Luang Prabang Mekong Dam Hydropower Info - by Hobo Maps - Go Back to Hydropower Web Page - - - HOME

The Luang Prabang Dam hydropower project site is located on the Mekong River about 25 km upstream from Luang Prabang town near Ban Houaygno and 4 km upstream from where the Nam Ou river joins the Mekong. The project affects Chomphet district in Luang Prabang province, Hongsa district in Xayabury province and Nga district in Oudomxay province.

Luang Prabang Dam site coordinates are 20°04'24.7"N 102°11'15.0"E (20.073528, 102.187500) as shown in satellite image below:

Concept image of what Luang Prabang Dam may look like below:

In March 2022 Thailand energy authorities announced that EGAT would soon sign a power purchase agreement for offtake of the project's power production.

Significant work has started on building access roads to the site including a new Mekong bridge and workers camps.

The project is expected to cost about US $3 billion and construction may begin in 2023.

Proposed Layout of Luang Prabang Dam site below:

Luang Prabang Power Company Limited is developing the project under a Memorandum of Understanding between the Government of Lao PDR and PetroVietnam Power Corporation. Thai-owned Ch. Karchang Company, which built the Xayaburi Dam, is in charge of construction.

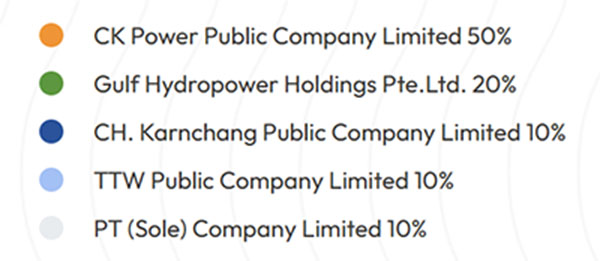

In late 2020 an ownership change occurred with the stock ownership of Luang Prabang Power Company Limited changed to the following:

PT Sole Co., Ltd. 38%
Petro Vietnam Power Corporation 10%
CK Power Public Company 42%
CH. Karnchang Public Company Limited 10%

In Oct. 2022 CKPower Plc planned to buy some of PT Sole Co. Ltd.'s shares which would bring its total shareholding to 50%.

The project will have installed capacity of 1,460 MW with yearly average capacity of 6,854 GWh (optimistic). It will operate under a concession period of 32 years from the Commercial Operation Date.

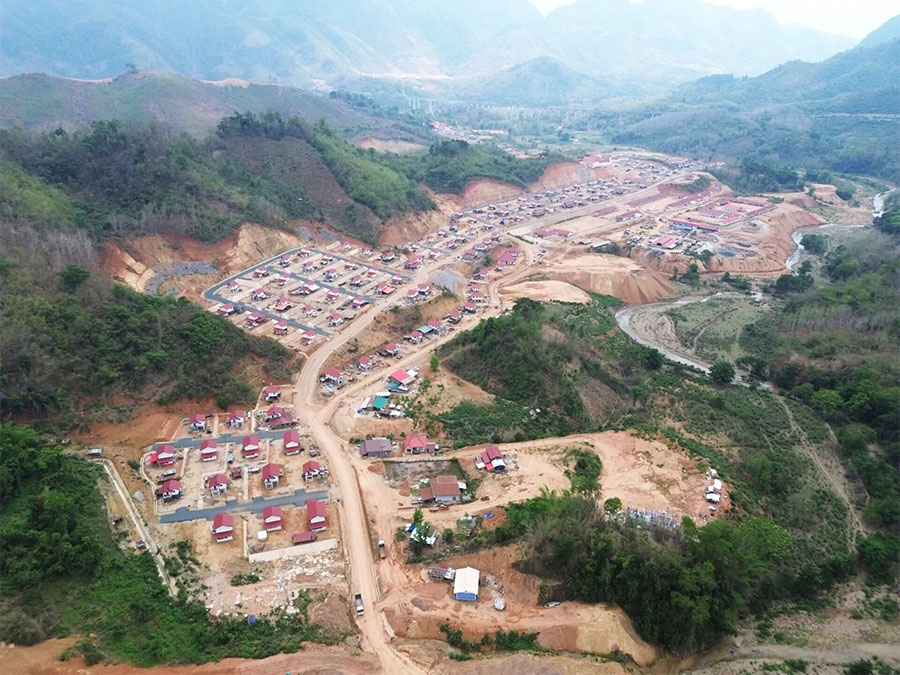

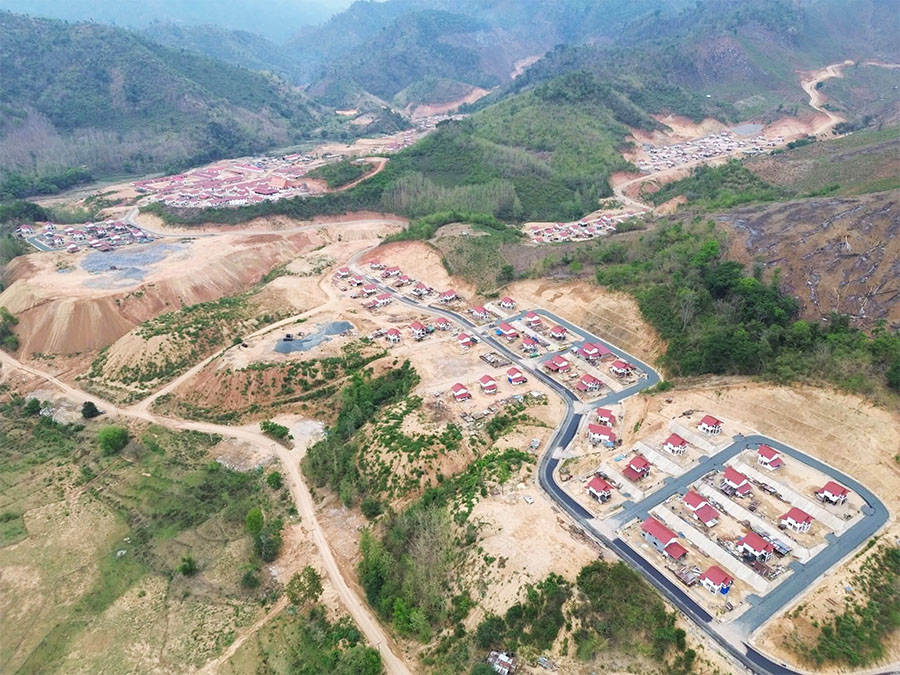

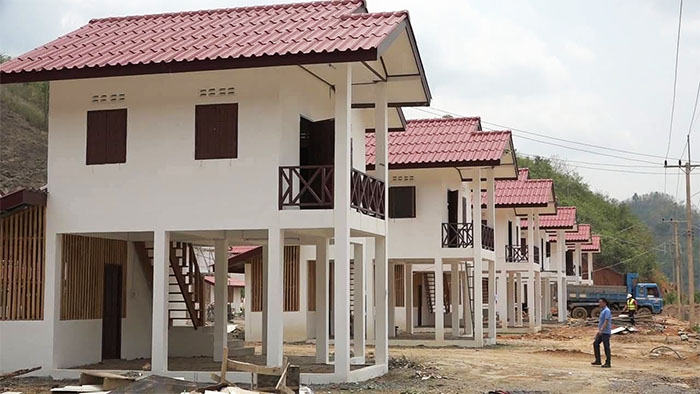

The project will displace 581 families ( 2,285 people) and impact 20 villages.

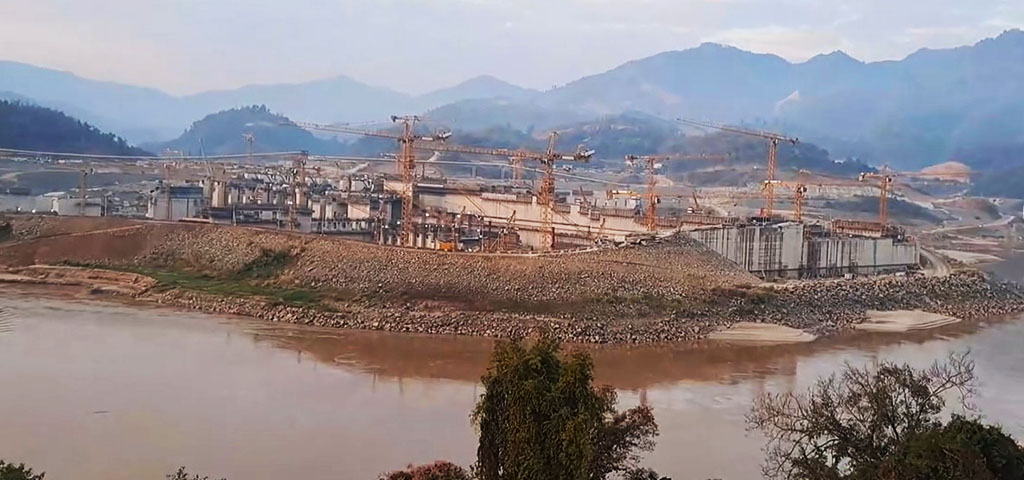

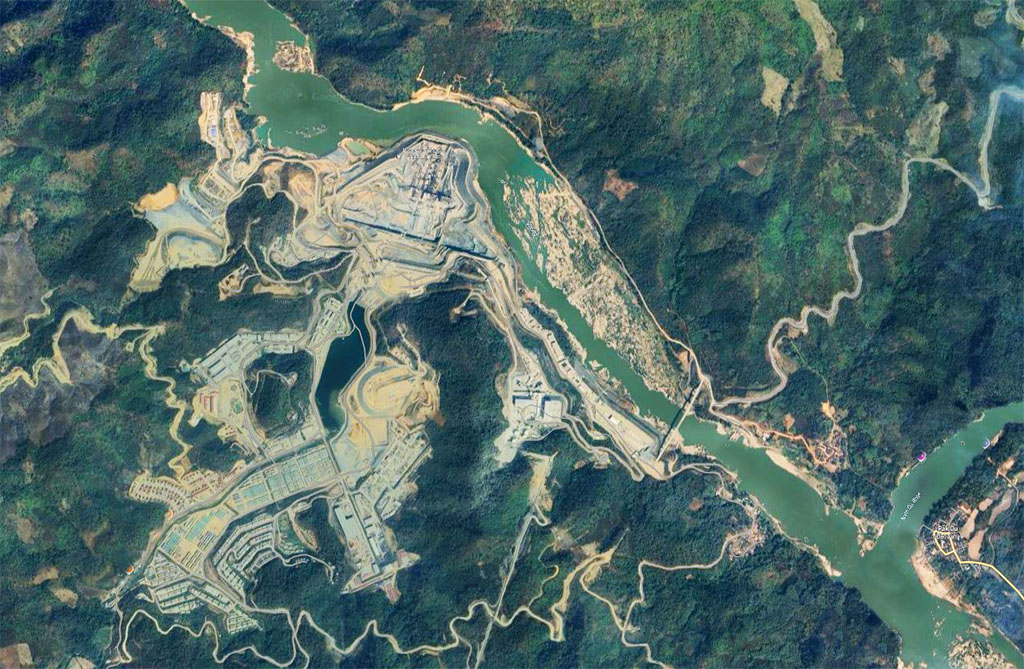

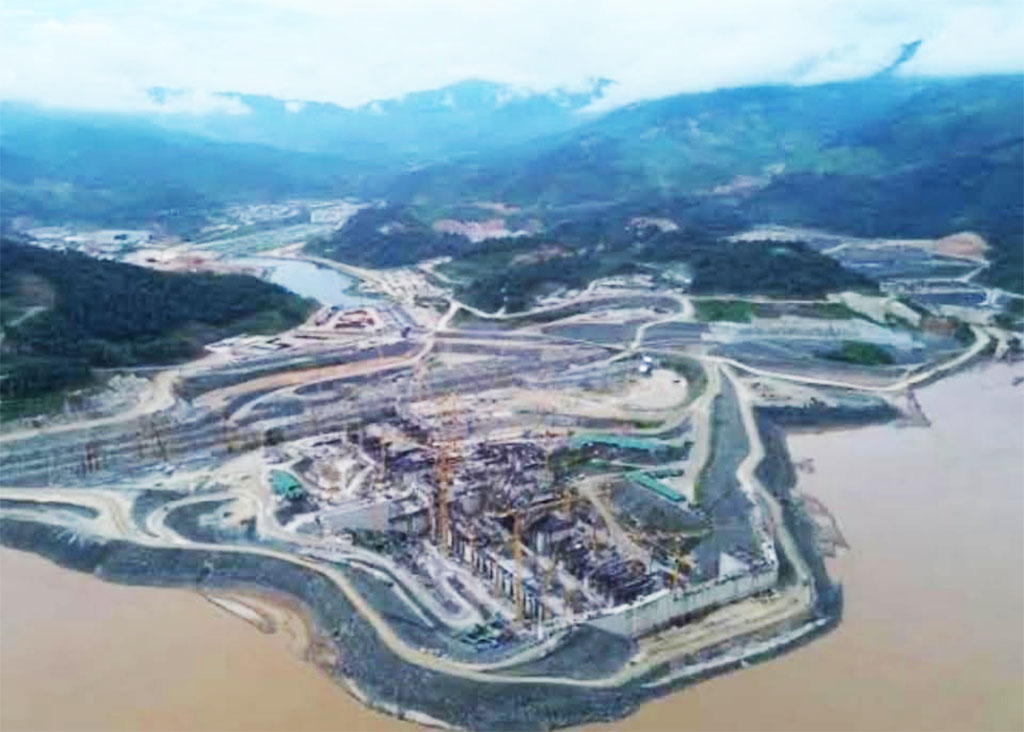

Luang Prabang Dam construction site satellite image below in 2022:

The main structures of the project are a navigation lock, spillway, powerhouse and dam structure. The dam crest elevation is 317 meters above mean sea level while the maximum dam height is about 79 meters over the deepest foundation.

A fish pass system providing facilities for upstream and downstream fish migration with multiple entrances is to be located along the powerhouse as well as in the left pier, right pier and on the right riverbank along the navigation lock. The fish migration system will be integrated into the powerhouse structure, the intake channel and the tailrace channel.

In January 2023 Andritz Group was selected to supply the hydro-mechanical package that includes design, manufacturing, supply, transportation, erection, testing and commissioning of seven large Kaplan turbine-generator units (203 MW output each) and three smaller units (18 MW each) including transformers, governors, control, excitation and protection and SCADA systems as well as the electrical power and associated auxiliary systems.

Images below show dam site construction progress in mid 2022.

The Project is designed as a run-of-river project with a barrage-type dam comprised of:
• A powerhouse equipped with seven Kaplan turbine/generator sets with total installed capacity of 1,400 MW and a maximum gross head of 36.80 meters
• Auxiliary turbine/generator units using water flow from the fish migration facilities provide a further 60 MW capacity
• A spillway structure with six radial surface gates
• A two-step navigation lock system for up to 500 ton vessels.
• A fish pass system for upstream and downstream migration.

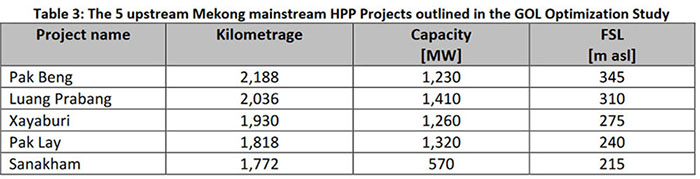

The maximum head difference between the upstream and downstream water level of this project is 35.50 meters. At the Full Supply Level (FSL) of 312 meters above sea level the Luang Prabang reservoir backwater will extend approximately 75 km upstream of the barrage almost to the planned Pak Beng Dam site. The Pak Beng Dam reservoir FSL is planned to be 340 masl.

As a Run-of-River type hydropower plant, the reservoir will be maintained steady for most of the time during operation and will only vary during spillway operations or other exceptional operating cases. The FSL operating range will be maintained between 312.00 and 312.50 masl. During flood operations, the three low level outlets and six surface spillway bays will discharge excess water not used for generation of electricity and/or operation of the Navigation Lock and Fish Migration Facilities. When the capacity of the low- level outlets is reached, the surface spillway will start operation. All gates of the Surface Spillway will be equipped with flap gates to allow spill of floating debris in front of the Spillway into the tailwater area.

Mekong River Commission Secretariat September 2019 PDF - LPB Dam Features

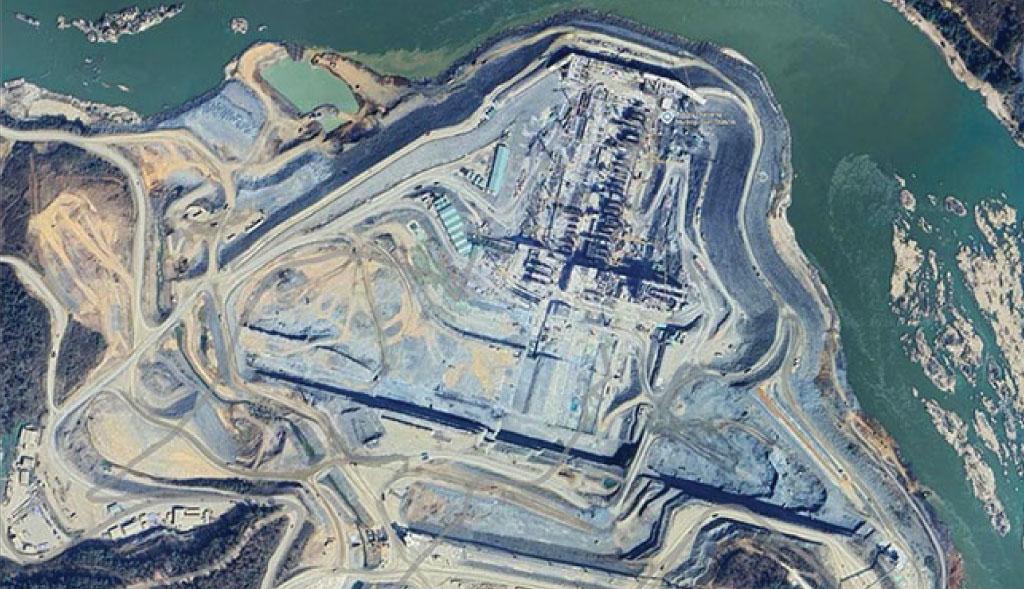

Image below shows dam site construction progress in mid 2022.

The dam structure is designed as a Roller-Compacted Concrete gravity dam with a height of 53 meters above foundation level and an overall length of 281 meters. The dam crest elevation is 317 meters above sea level and the foundation level is at 264 meters above sea level. The width of the crest is 12 meters.

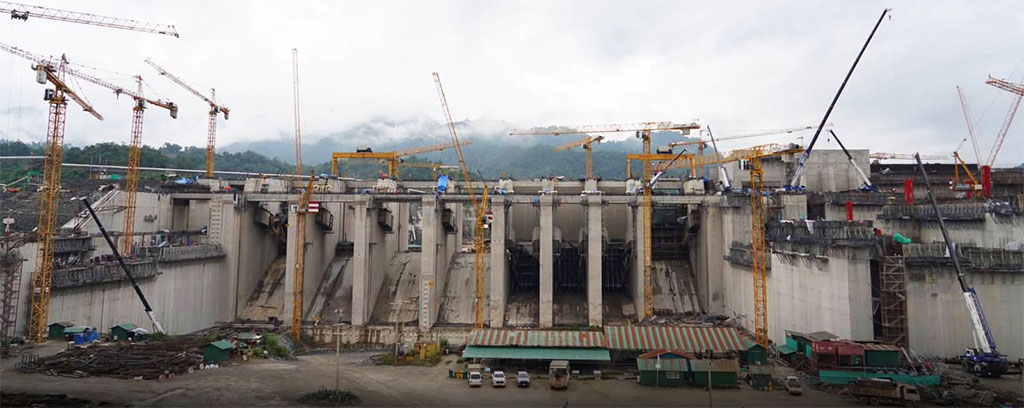

Image below shows dam site construction progress in mid 2022.

Spillways: The spillway overflow consists of six high-level surface bays at 288 masl and three sediment-flushing low-level outlets at 275 masl. Each of the surface bays is equipped with a Gantry crane, flap gates (to allow floating debris to overflow into the tailwater area) and a service gate (radial gate) operated by hydraulic cylinders.

The surface spillways have a design discharge capacity of 4,850 cubic meters per second while the low-level outlets have capacity of 3,530 cubic meters per second. The spillways are designed to accommodate a 10,000-year flood (same as the the existing Xayaburi Dam design).

Image below shows dam site construction progress in mid 2022.

Backwater Effects: At the Full Supply Level of 312 meters above sea level the reservoir backwater effect will extend about 75 km upstream of the barrage almost to the planned Pak Beng Dam. Pak Beng town will have a new minimum Mekong level (just as L. Prabang town now has a minimal Mekong level from the Sayaboury Dam backwater affect).

Navigation Lock: The navigation lock is at the right riverbank and uses a two-step system for transit of vessels up to 500 tons by dividing the total lifting height of 35.5 meters into two equal parts. The time for transit through the two-step ship lock is expected to be about 50 minutes and may provide additional fish passage during migration periods.

Fish Migration Facilities and Impacts: The project design includes fish migration facilities to sustain the life cycle and populations of long distance migratory white fish species found in the upper zone of the Lower Mekong Basin. Upstream and downstream fish migration systems will be integrated into the powerhouse structure, intake channel and tailrace channel.

Fish migration facilities are intended to sustain the life cycle and populations of long-distance migratory white fish species currently found in the river where the project is located. The project aims to meet the requirements of the MRC Preliminary Design Guidance 2009 and function like the Xayaburi HPP fishpass system but without a separate fish pass channel.

Downstream fish migration through the powerhouse: A collecting gallery installed above the powerhouse intakes and a downstream stepped chute (exit chute) to the tailrace channel will be built to support fish migrating downstream. Mortality for smaller fish through the turbines will be minimized due to the turbine design while larger fish will be diverted by the trash racks to the collecting gallery. Fish migration will also occur via the spillways when they are in operation.

The upstream migration system comprises multiple entrances along the powerhouse, a collecting system and two fish locks at the left pier with outlets into the headwater. The downstream migration facility provides entrances above the power intakes where fish are spilled via a stepped downstream chute at the right pier into the tailwater. The water from the attraction flow is used for electricity generation at the auxiliary units.

Upstream fish pass facilities include fish locks at the powerhouse and multiple entrances along the downstream face of the powerhouse and at the left pier. Fish in these collection galleries are guided by attraction currents to two parallel fish locks, including a fish crowder and movable screen floor, where the fish are lifted up into the headwater of the reservoir.

Mekong River water level chart below for Mekong at Luang Prabang town. Current water level at 276 masl in Nov. 2022 matches the backwater full supply level of 275 masl for Sayaboury Dam HPP and shows that the backwater pond does reach all the way to L. Prabang. Updated chart from Mekong River Commission website page can be seen HERE.

Maybe it's a good time to prepare a flood emergency plan:

Also see our web page for Luang Prabang Flood Impact Info

Luang Prabang Dam hydropower project has received an agreement from Electricity Generating Authority of Thailand (EGAT) to purchase output from the project but details are not yet clear and the transmission line export route has yet to be disclosed. The export map below shows a possible route along with other export lines. See a larger version of this map HERE.
